              24





            Geotechnical News • June 2016





            GEOTECHNICAL INSTRUMENTATION NEWS



          where engineers can access it. This


          is achieved by hooking up a cellular


          modem to the logger and setting up


          scheduled data transfers. This passive


          method of data retrieval is well-suited


          for this application since we were


          confident that the generated vibration


          from tunnel construction would never


          exceed the threshold, thus eliminating


          the need for real-time alarms.



            Lessons learned



          Despite a smooth start, unforeseen


          equipment failures forced us to


          quickly review our setups and devise


          an action plant to ensure as little data


          as possible would be lost. Of the


          failures, the most common one was


          unreliable cellular modem communi-


          cations. The modems would hang and


          generate issues in the transferred data,


          and create doubts regarding system


          reliability. There was a very real risk


          that tunnel construction would go on


          without our system continuously pro-


          viding evidence that bylaws and other


          requirements were being followed. In


          this context, a well-prepared contin-


          gency plan is a necessity to ensure full


          protection for the client.


          Beyond these hiccups, the main lesson


          learned from this project is not about


          choice of instruments, installation


          or data analysis. The main challenge


          proved to be communicating effi-


          ciently with the client. On several


          occasions, we have gone over with the


          client how the system works, how to


          configure it and how to extract data.


          Despite offering training sessions and


          providing several training documents,


          the client still had difficulty maintain-


          ing and using the vibration monitoring


          equipment.


          There was a fairly high turnover rate


          for the people in charge of this equip-


          ment, and information would be lost


          from person to the next. Compounding


          this issue, the people in charge have


          often been temporary student workers,


          which almost guarantees their contract


          ends before their successor is hired


          and thus that they had not passed on


          their knowledge correctly before leav-


          ing. In the context of ensuring compli-


          ance to the project requirements, it is


          necessary to plan with the client how


          knowledge will be transferred from us


          to them and maintained within their


          team.


          In short, the general outline of vibra-


          tion monitoring was followed: vibra-


          tion sources and limits were identified;


          instruments and measurement loca-


          tions were chosen accordingly; and


          the system was set up according to the


          requirements. The main lesson drawn


          from this project is that for the system


          to work as intended, communica-


          tion with the client and technological


          transfer are almost as, if not more,


          important than the technical aspects of


          the system.



            Project 2





              Technical requirements




          Large cracks running along several


          hundred meters in a large wastewater


          sewer compromised security during


          infrastructure work in the vicinity of


          the tunnel. A collapse of the sewer


          could lead to flooding with wastewa-


          ter in a very densely populated area.


          Given the length and the width of the


          cracks (over 5 cm), very stringent


          vibration criteria were set: vibration


          should never exceed 2 mm/s for low


          frequency. Similarly, cracks should not


          open or close at all during infrastruc-


          ture work in the vicinity. In conse-


          quence, two main types of instruments


          were used: 12.5 mm-range vibrating-


          wire crackmeters and geophones.


          In both cases, data are retrieved in a


          trailer where an engineer continuously


          monitors vibration and crack defor-


          mation. The vibration dataloggers


          are linked to a cellular modem which


          can transfer data to a server. Special


          software monitors incoming data and


          sends out alarm e-mails as needed.


          In most projects an alarm e-mail sent


          out within 15 minutes of vibration


          exceeding the threshold is considered


          satisfactory. The major public safety


          risk that a collapse would cause made

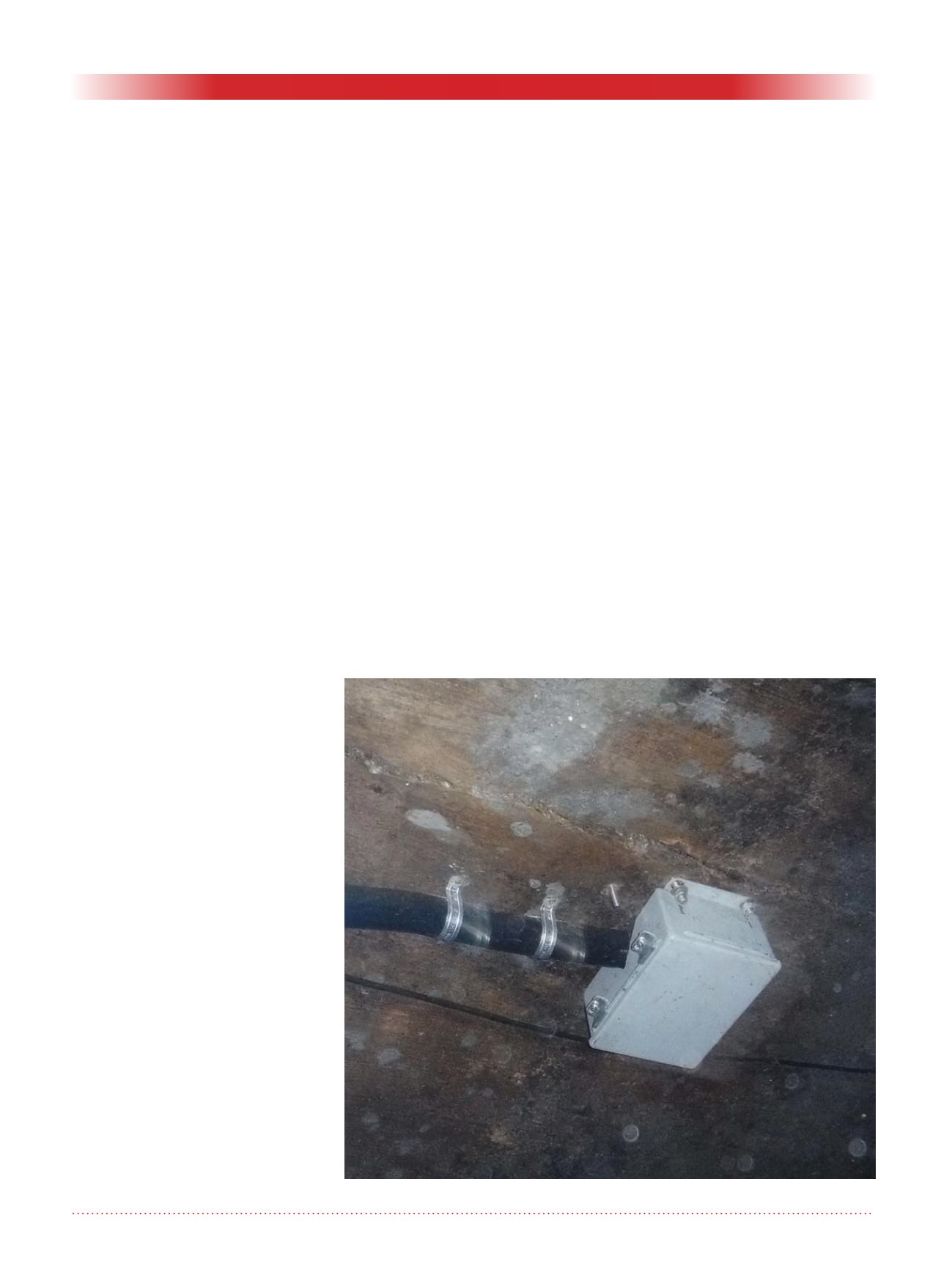

            Figure 2. A geophone installed in a wastewater tunnel.
