            Geotechnical News •   June 2016





              21





            GEOTECHNICAL INSTRUMENTATION NEWS



          5. Clarify how the specified require-


          ments will be enforced, and


          specify clear financial penalties in


          case of non-compliance. Be aware


          that a specification for uninterrupt-


          ed measurements with less than


          four hours downtime for repairs


          will lead to high service cost for


          those who respect the specifica-


          tions. Indeed, the monitoring


          contractor will need to have one or


          more highly trained specialist(s),


          equipped with all repair and


          replacement equipment, paid on-


          call, and probably housed in close


          vicinity to the project.



            Monitoring budget and




            procurement





              Rule number 3: Ensure that there is






              an adequate monitoring budget. Allo-






              cating an insufficient budget might






              end up in wasted money.




          Often given insufficient attention,


          sometimes forgotten, the budget


          allocated to the monitoring will have


          a major influence on the quality and


          usefulness of the data that will be


          obtained. For geotechnical construc-


          tion a general rule of thumb is that


          1% to 2% of the construction budget


          is generally adequate for a compre-


          hensive monitoring program. Of


          course this in only a general idea as,


          following rule number 1, the extent


          of monitoring depends on the project


          needs, in particular the degree of risk.


          On a site with no risks the budget can


          be zero, on a site with complex issues


          the budget could be 4% or more. With


          proper monitoring put in place, risks


          can be significantly reduced, therefore


          potentially saving huge costs. Alter-


          nately, if the monitoring budget is too


          low, the data provided may be of such


          bad quality that it will prove unus-


          able, and whatever small amount was


          spent on the monitoring will be wasted


          money.




              Rule number 4: No low-bid procure-






              ment for services of the monitoring






              contractor




          Selecting the monitoring contractor


          based on low-bid is not recommended.


          In North America the practice is very


          much state/province dependent, but


          in most cases the low-bid method is


          selected, whether in public or private


          tenders.


          In Europe the technical proposal is


          now considered carefully in public


          tenders, and acceptance is regularly


          given to the best proposal after an


          analysis of both cost and technical


          issues. However in private tenders,


          i.e. when the monitoring contractor is


          selected by the construction contrac-


          tor, then in most case the low-bid will


          be chosen.


          This brings further case to the defend-


          ers of the fact that the monitoring


          contract is better placed directly


          with the owner, rather than through a


          construction contractor. This subject


          has already been much discussed in


          previous GIN issues.


          One could argue that it is up to


          monitoring contractors to avoid low


          bidding. It is a complex decision to


          decide on the financial limit below


          which it is better not to do the job. But


          accepting a contract below that finan-


          cial limit will result in not being able


          to provide quality data, thus putting


          both the job and the company’s reputa-


          tion at risk.



            Project management





              Rule number 5: Provide strong






              enforcement of the specifications.




          It is important for the owner and the


          project designer to ensure they will


          have the power to demand high qual-


          ity data during the project duration.


          It is not as trivial as it may appear to


          enforce, during the contract, what was


          stated in the specifications: the pres-


          sure of the day-to-day site activities,


          the complexity of leveraging on a


          contractor or, even more complicated,


          a construction contractor’s subcontrac-


          tor, all lend themselves towards cut-


          ting corners and taking liberties with


          the specifications. Financial penalties


          are a possible way to maintain this


          pressure. This is only achievable if the


          specifications state clearly the rules,


          enforcement and verification of those


          rules.



            Monitoring contractor





              Rule number 6: Ensure that the






              monitoring contractor’s team is expe-






              rienced and focused on data quality.




          Even with modern day automatic


          instruments, the final quality of the


          monitoring relies mainly on the qual-


          ity of the monitoring contractor’s team


          on site and off site.


          The project manager on a large moni-


          toring site acts as the leader for the


          whole team. The project manager is in


          a difficult position in that he is also the


          guarantor, on behalf of his company,


          of the financial success of the project.


          A good project manager will under-


          stand the necessary balance between


          financial and technical success. The


          search for data quality must be at the


          forefront of the whole company and


          hierarchy to ensure the proper deci-


          sions are taken, even in difficult times.


          The whole team should be trained


          regularly to be able to perform tasks in


          an optimum manner. Many monitoring


          tasks appear simple at first, but can


          easily lead to false results when not


          carried out properly. At least one engi-


          neer, not necessarily the project man-


          ager, should be the quality “control


          tower”, capable of solving any specific


          technical difficulties, and training the


          team to check their readings and to


          detect their own mistakes. It is desir-


          able to have a good proportion of the


          monitoring team, and especially those


          in direct contact with the owner and

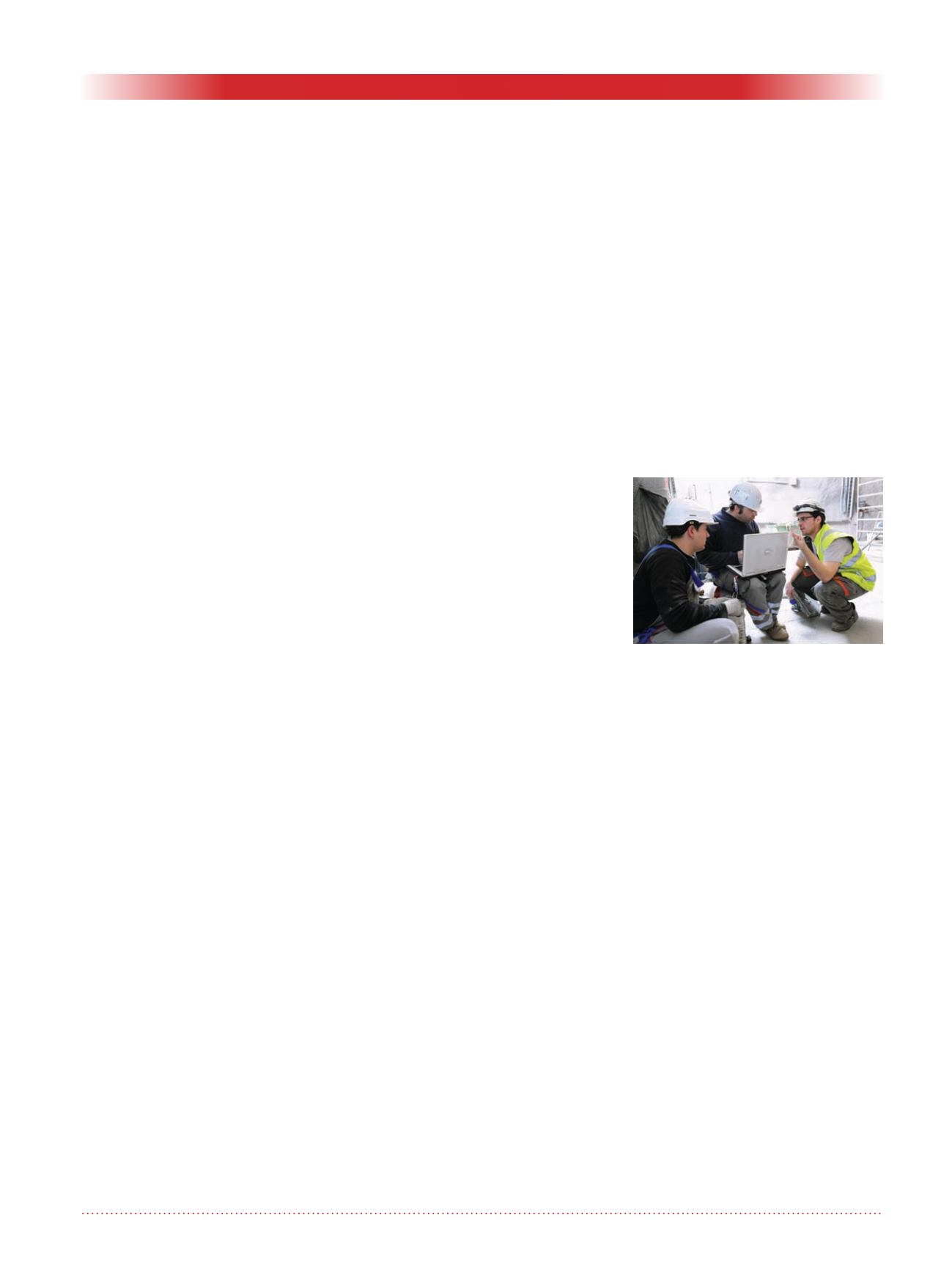

            Figure 2. Team work and under-




            standing what we measure. Credit:




            Comet Photoshopping / Dieter Enz
