              28





            Geotechnical News •  June 2017





            THE GROUT LINE



          underground floor, in narrow spaces


          (the average height was 2,30 m) (Fig.


          7).


          The structures were controlled by an


          automatic topographic monitoring


          system (Fig.8); optical prisms were


          placed in correspondence of each


          pillar.


          The grouting scheme was studied in


          order to gradually uplift the structure’s


          pillars; in some cases even the specific


          order of the sleeves to be injected


          was indicated. On the first day, a set


          of holes was drilled and the sheath


          injection executed. On the following


          day, the first stage of the injection,


          using cement grout, was carried out.


          The monitored points were regularly


          checked. The operative parameters


          were recorded in real time and the


          pressure and volumes evaluated at


          the end of each working day. In some


          cases, the data analysis involved


          rescheduling the grouting sequence


          of the following days. The continuous


          and constant monitoring and recording


          of the grouting parameters influenced


          the timing and scheduling of the proj-


          ect. On several occasions the weekly


          scheduling was modified based on the


          results obtained day by day. In some


          cases, the weekly programming was


          modified based on the data and results


          obtained on a specific day.


          The chart of figure 9 shows the evolu-


          tion of the vertical displacements


          measured during the works. Firstly the


          grouting with cement mix gradually


          uplifted the pillars nr. 8 and 9.

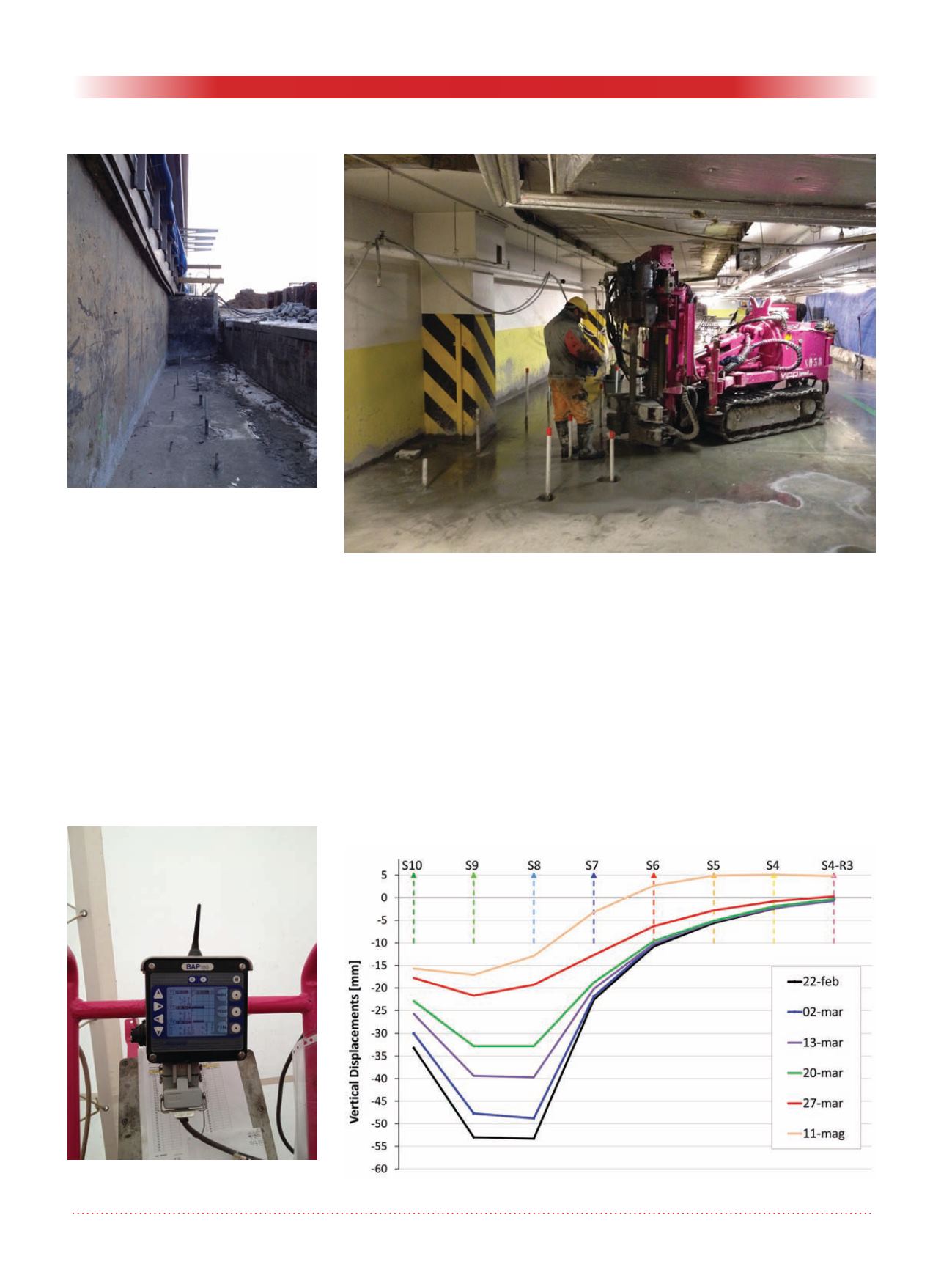

            Figure 6.Two rows of TAM outside




            the structure, installed from a




            lowered existing level.




            Figure 7.Drilling works from the underground parking inside the building.




            Figure 8.Topographic monitoring




            system.




            Figure 9. Pillars’ displacements during the grouting works.
