            Geotechnical News • March  2015





              31





            GEOTECHNICAL INSTRUMENTATION NEWS




            Lesson learned from two case histories about the planning of




            integrated monitoring systems




            Francesca Bozzano




            The primary lesson



          During the past eight years as an engi-


          neering geologist on a research team


          studying geological risks, I have made


          use of integrated systems to monitor


          and manage ongoing instability pro-


          cesses. These have included landslides


          and ground subsidence. In our moni-


          toring systems, contact instruments


          and remote techniques have been used


          for monitoring.


          This article presents the primary les-


          son learned from two case histories:


          that a general inverse relationship


          exists between the level of understand-


          ing about the ongoing geological/


          geotechnical process and the complex-


          ity (and cost) of an efficient monitor-


          ing system. Said another way – the


          more we understand the process, the


          less is the complexity and cost of the


          monitoring system. In Figure 1, our


          understanding of ongoing process is


          shown at the left, in which the scale


          indicates low-level (L), medium-level


          (M) and high-level (H) of understand-


          ing. The complexity (and cost) of the


          corresponding planned monitoring


          system is shown at the right.


          The red bars represent case histories


          characterised by an



            a




            priori



          low-level


          understanding, for which a highly


          complex and integrated monitoring


          system must be planned and executed


          to close the information gap. The


          green bars represent case histories


          characterised by an



            a




            priori



          high-level


          understanding, for which a simple


          and integrated monitoring system can


          perform well.


          Based on the lesson summarised in


          Figure 1, efforts should be placed on


          acquiring and organising qualitative


          and quantitative information about a


          specific process in firm reconstructions


          using an approach that is largely used


          in engineering geology. This approach,


          which is known as the geological


          model, is a very good planning tool for


          efficient monitoring systems.


          In the next section, two opposite case


          histories are described: the first case


          history is representative of a low-level



            a priori



          understanding of an ongoing


          process; the second case history is


          representative of a high-level



            a priori



          understanding of an ongoing process.



            Case history 1



          The first case concerns an unstable


          slope that delayed the construction of


          tunnels along a highway in southern


          Italy. In February 2007, the tun-


          nel entrances were destroyed by an


          unexpected translational landslide


          when the length of the excavated


          tunnel was approximately 12m. The


          volume of the landslide was approxi-


          mately 10,000m


          3


          , which included


          metamorphic rock debris from the


          adjacent steep slope. At that time, the


          tunnel alignment could not be changed


          and stabilisation of the landslide was


          imperative.


          Geological and geomorphological


          surveys enabled us to discover that the


          landslide was embedded in an older


          and larger and deeper quiescent/inac-


          tive rotational landslide with a volume


          of approximately 1,000,000m


          3


          . The


          2007 shallow landslide was located at


          the toe of the older and larger land-


          slide, and was triggered by the tunnel


          excavation.


          In the following months, three bulk-


          heads (Figure 2) anchored using 30m


          long tiebacks were placed along the


          slope to stabilise the shallow part of it.


          An integrated monitoring system was


          planned by considering uncertainties


          in the volume of the ongoing instabil-


          ity process, i.e., small instabilities


          in the shallow section of a quiescent

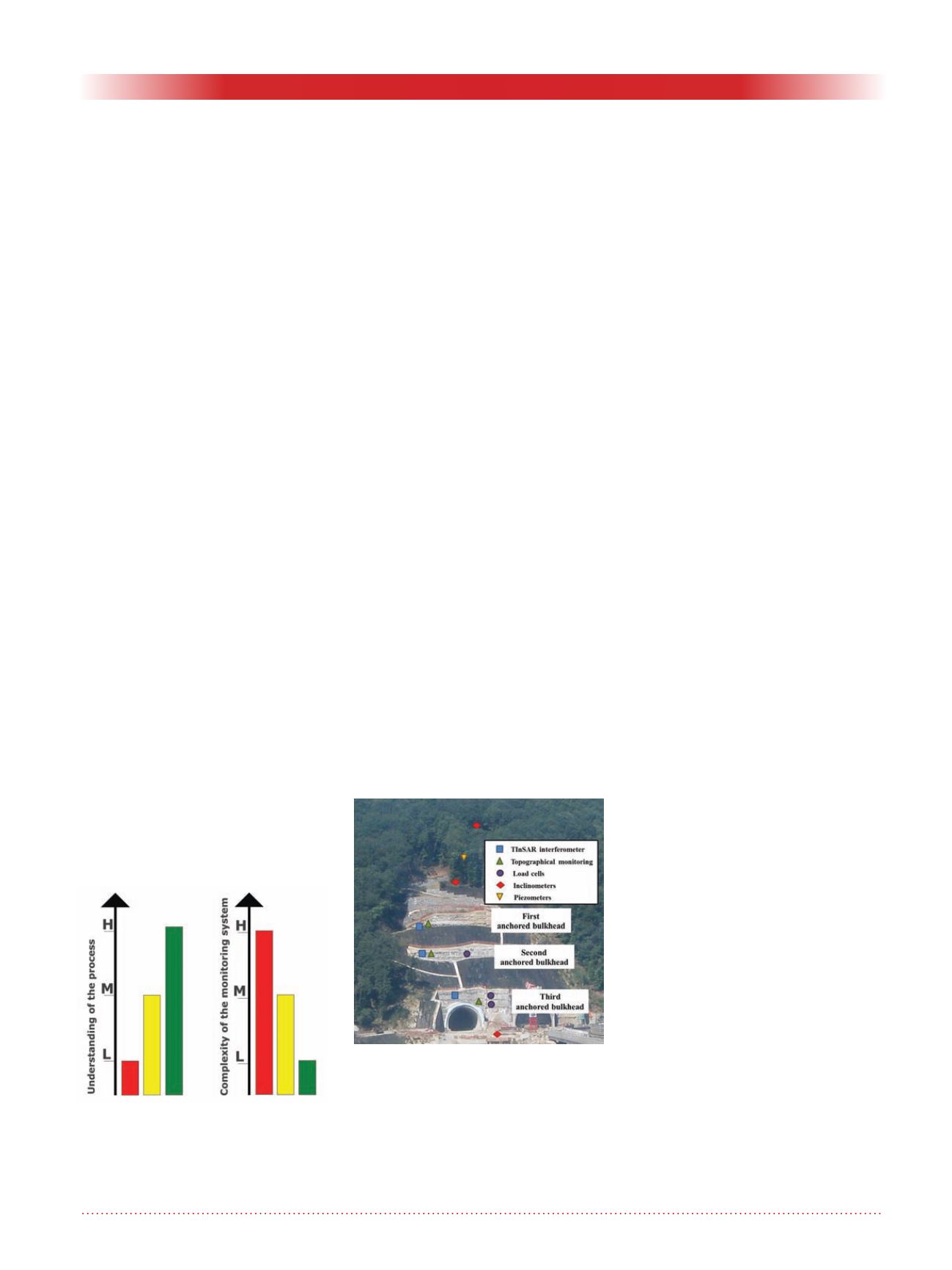

            Figure 1. Sketch of the relationships




            between the level of understand-




            ing for an ongoing process and the




            complexity (and cost) of the moni-




            toring system.




            Figure 2. Photograph of the slope,




            which shows the three anchored




            bulkheads and the location of the




            monitoring instrumentation. The




            symbols for TInSAR monitoring and




            topographical monitoring indicate




            that they specifically observe the




            bulkheads.
